Flat Roof on a Family House: Build-up and Waterproofing

8 min read

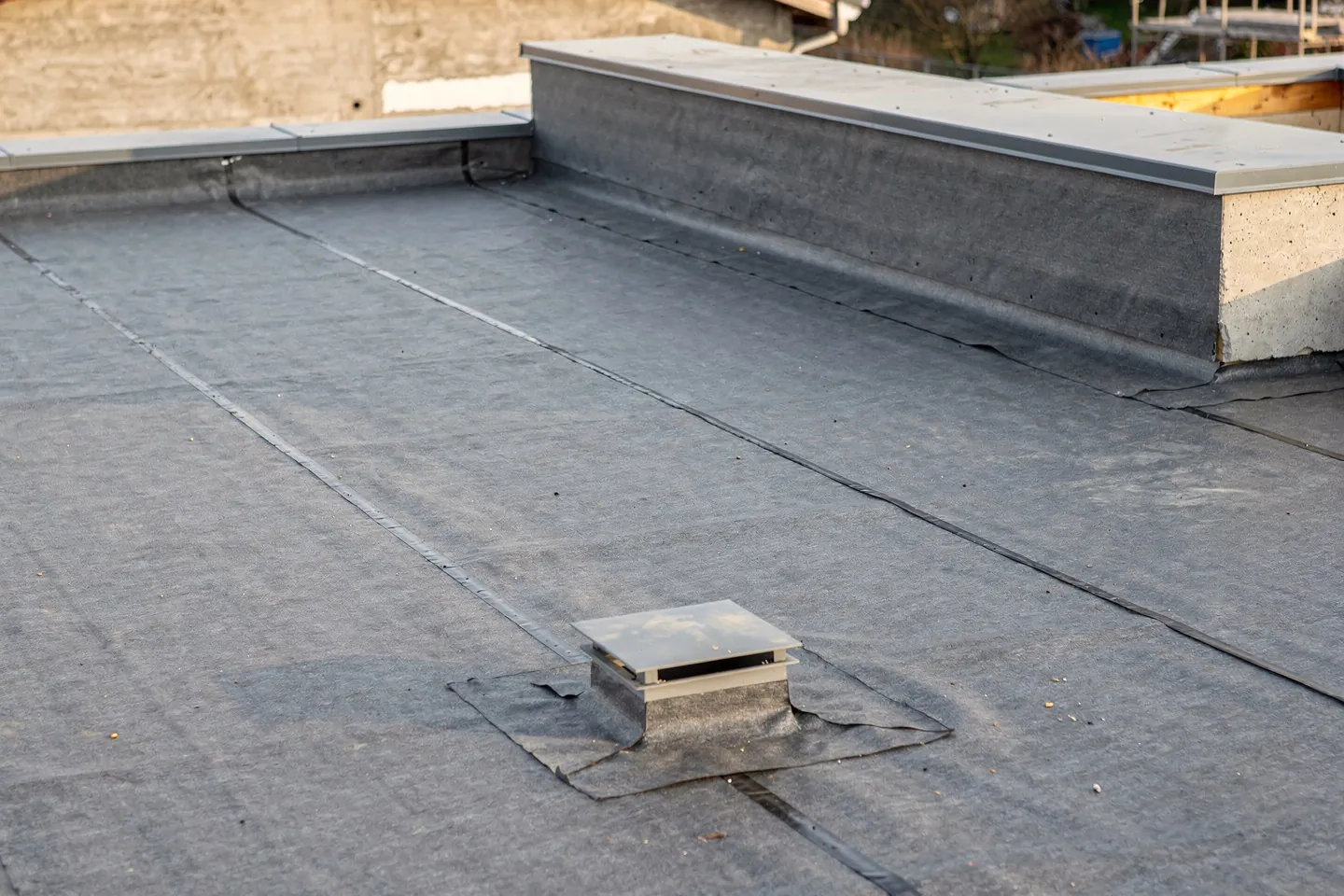

A flat roof on a single-storey house under construction with a grey synthetic membrane laid over tapered insulation boards, a welded seam, a square roof outlet at the low point and a low parapet with metal coping

Why do flat roofs leak, and how can you prevent it?

A house with a flat roof has no covering that sheds water. Water must run off along the falls and the waterproofing must be continuous. The US guide UFC 3-110-03 (edition of 1 May 2012, change 2 of 1 January 2017) covers roofs with a membrane.

The same guide lists rules for any roof with a membrane. Drain the roof without ponding, limit the number of penetrations, keep maintenance items accessible, control access to the finished roof and inspect it regularly. It is a US military guide, not a Slovak rule, but it shows where a membrane gets damaged. Roof coverings: tile, metal or membrane compares coverings.

Flat or pitched roof: what decides?

A pitched roof sheds water through its covering. A flat roof holds the water back with a continuous membrane. UFC 3-110-03 divides roofs the same way: membrane systems on low slopes and water-shedding coverings on steep slopes. A flat roof forgives mistakes less, because water stays on it longer.

The spatial plan can decide too. Decree 392/2023 lists a roofing regulative among the optional regulatives of a municipal plan. It sets the allowed or banned roof type and a minimum or maximum pitch. A colour regulative is also listed (§ 2 písm. aw and ax, § 16 ods. 3 písm. i and j). A zone plan has the same options in § 16 ods. 6 písm. c and d. Construction is allowed only in line with the binding part of the planning documentation (Act 25/2025, § 21 ods. 1). Before the first sketch, get the municipal land-use plan and check whether a roofing regulative exists for your plot.

If the house is a cultural monument or stands in a monument zone, the regional monuments office also decides. For a property in a monument zone, it issues a decision on the intent of the works and sets conditions. These cover the massing, the height arrangement and the architectural design of the exterior (Act 49/2002, § 32 ods. 5 and 7).

Warm, inverted or cold roof?

Choose the build-up before you choose the waterproofing material. Three arrangements are possible on a family house.

  • Warm roof. From below: the structural deck, a vapour control layer, the thermal insulation and the waterproofing on top (warm roof). If water gets through the waterproofing, it can spread in the insulation. The stain on the ceiling then appears away from the hole.
  • Inverted roof. The thermal insulation lies above the waterproofing, not below it (inverted roof). UFC calls this a protected membrane roof. It states that extruded polystyrene (XPS) resists moisture better than expanded polystyrene (EPS) and suits inverted systems.
  • Cold roof. A ventilated air gap sits above the insulation, and an upper deck with the waterproofing sits above the gap (cold roof). It works only when air really flows in the gap.

The vapour control layer must be continuous. UFC says a calculation decides whether the layer is needed and where it belongs. It also says moist air leaking through a badly installed layer defeats its purpose. A structure must be built from products and materials suitable for the intended use (Act 25/2025, § 19 ods. 2). Ask the designer for the build-up calculation.

Which waterproofing membrane should you choose?

The choice depends on the build-up, the substrate and what will sit on the roof, not on the brand. UFC 3-110-03, section 2-8, describes these main groups of membranes.

  • Bitumen membranes. UFC calls built-up bitumen systems a dependable solution for low-slope roofs, with a long service life and low maintenance.
  • PVC and TPO. The seams are welded with hot air. UFC says properly welded seams match the strength of the sheet. The membranes come in many colours. A properly built system may last 15 years or more.
  • EPDM. Large sheets with factory seams. For a system loaded with stone or pavers, UFC gives a weight of 49 to 59 kg/m2 and notes that leaks are harder to find.

Materials that do not tolerate each other must not touch. UFC says the type of plasticiser in PVC decides under which conditions the membrane may be used. Ask the system manufacturer to state in writing that each layer is compatible with its neighbours.

What falls, outlets and emergency overflows does a flat roof need?

The smallest fall depends on the build-up, the membrane manufacturer and the standard. This article gives no figure, because the standard is paid and no free source was found. The designer sets the value for your roof and writes it in the project.

Falls are often made with tapered insulation boards. UFC says four-way tapered boards are the most effective way to drain a roof, followed by two-way boards with saddles. The outlet goes at the lowest point of the roof. If the roof has a parapet, it also needs an emergency overflow through the parapet, set above the outlet level. UFC defines such a channel as a safety overflow that limits ponded water when drains clog or rain is intense. Rainwater: harvesting and use covers what happens to the water after that.

Where do flat roofs leak most often?

A membrane is weakest where it is interrupted or changes direction: at the parapet, at outlets, at penetrations and at terrace door thresholds. Penetrations such as soil vent pipes, chimneys, rooflights or railing anchors belong in system collars, away from the parapet and the outlets.

The vapour control layer must connect to outlets, parapets and penetrations as carefully as the membrane, because the whole build-up depends on its continuity.

What can sit on the roof: a terrace, greenery or PV?

Decide this before you design the build-up, because it sets the load, the access and the number of penetrations.

  • Terrace. UFC recommends controlling access to the finished roof and marking walkways, so the membrane is not punctured or damaged.
  • Green roof. It adds weight and a planting layer that makes leaks hard to find. UFC recommends electric leak detection mainly for membranes covered with soil. The next section covers what a green roof needs.
  • PV. A photovoltaic panel loads the structure, and each anchor through the membrane is a penetration, so the structural engineer decides on the load. A device up to 50 kW inclusive that produces electricity from renewable sources needs no decision on the building intent. It needs no notification either (Act 25/2025, § 18 ods. 5 písm. i). Yet § 18 ods. 4 písm. b) requires notification for solar devices, including devices integrated into a building, and for those from 50 to 100 kW inclusive.

Can a flat roof be greened, and what does it need?

A green roof is a roof structure that carries wet substrate, roots and water. An extensive green roof has a thin substrate and drought-tolerant plants, and people do not usually walk on it. An intensive one is a roof garden with thicker substrate, lawn and paths. The system maker gives the figures, and a structural engineer checks them.

The structural engineer is the first step. The load that counts is the one after rain, when the substrate is full of water. It adds to snow, wind and the roof's own weight.

The green roof build-up reads from the bottom up. On a warm roof, the green layers lie directly on the waterproofing. On an inverted roof, the waterproofing lies on the structure and the insulation above it. The system maker must support the chosen build-up, so ask for that in writing.

  • Waterproofing that resists root penetration, or a root barrier.
  • A protection and filter layer.
  • A drainage layer that carries off excess water and holds some back for the plants.
  • Substrate made for roofs, not garden soil, and vegetation.

What does a green roof do with rain, and is there a subsidy?

The substrate and the drainage hold back part of the rainfall, and the rest runs off more slowly. This is rainwater retention on the roof. Bratislava gives a contribution for rainwater management and lists vegetation roofs among the supported measures. It is up to 50 % of the costs incurred and at most 1,000 EUR per applicant, paid after the project is done. The owner or administrator of the property can apply. According to the city page, no call opens in 2026 (checked on 11 November 2026). Elsewhere, ask the municipal office.

Does the membrane colour affect overheating?

A dark surface absorbs more sunlight. Berkeley Lab describes solar reflectance as a value from 0 to 1, and thermal emittance as how efficiently a surface cools itself by emitting radiation. The solar reflectance index (SRI) is a temperature scale calculated from both values. A clean black roof has an SRI of 0 and a clean white roof has 100. The higher the SRI, the cooler the roof in the sun.

How much the colour changes the temperature of the rooms under a well-insulated roof depends on the build-up, so this article gives no figure. On inverted and green roofs the colour does not matter, because the membrane is covered.

Do you need a permit to repair or replace a flat roof?

For repairing or replacing the surface of a flat roof, usually not. Under § 18 ods. 5 písm. a) bod 1 of Act 25/2025, you need no decision on the building intent and no notification for these works. They are the repair or replacement of the roof covering or of the surface of flat roofs, and the replacement of gutters and downpipes. The act no longer issues building permits, a decision on the building intent replaced them. Renewing the roof envelope is a building alteration (§ 2 ods. 9 písm. a). That is also exempt from decision and notification (§ 18 ods. 5 písm. k), until a case from § 18 ods. 3 applies. Examples are work on a building in a monument zone (písm. g) or work that may endanger human health, mechanical resistance or stability (písm. h). A green roof on an existing house is usually such an alteration of the roof envelope. The added load of the substrate may be a case from písm. h. Then notification to the building office is required (§ 18 ods. 3), so have the structural engineer assess it first.

The act also requires notification for maintenance that could affect stability, fire safety, the look in the public space or the environment. It requires notification for maintenance of a cultural monument too (§ 18 ods. 4 písm. c and d). The act does not say how these cases combine with ods. 5. If you change the build-up or the shape of the roof, ask the building office. Restoration of a cultural monument includes maintenance and repair. Before it starts, the owner must ask the regional monuments office for a decision on the restoration intent (Act 49/2002, § 32 ods. 1 and 2). From 1 January 2027, Act 243/2026 rewrites § 18 ods. 4 (Art. I, bod 62). Notification is then required for maintenance that may affect stability, fire safety or the environment. It is also required for every maintenance of a cultural monument. For a building in a monument zone that is not a monument, it is required when the maintenance changes the outward appearance.

How do you inspect a flat roof and find a leak?

UFC recommends preventive maintenance with regular inspections and timely repairs. This article gives no interval. You will find it in the membrane manufacturer's warranty terms. Before a renovation, UFC starts with a survey of the roof. The survey includes a visual inspection, an infrared moisture survey and analysis of samples cut from the build-up. A stain on the ceiling seldom shows where the defect is, so these methods are used.

  • An infrared moisture survey looks for wet areas in the build-up.
  • Electric field vector mapping (EFVM) is non-destructive. The surface is wetted, a low voltage is applied above and below the membrane and the current is measured. UFC recommends it mainly for membranes covered with soil, pavers or an inverted build-up. It suits membranes that insulate electrically.
  • A cut through the build-up shows how far the water has spread and whether the insulation still works.

Frequently asked questions

Do flat roofs leak more often than pitched roofs?
That is not true by itself. A flat roof has no covering that sheds water, so everything depends on continuous waterproofing, drainage and details. Faults in them show sooner on a flat roof, because water stays on it longer.
Can you walk on a flat roof?
For inspection, yes, but walking can damage the membrane. UFC recommends controlling access to the finished roof and marking walkways. If you go on the roof regularly, for example to reach PV, agree walkways with the membrane manufacturer.
Can a flat roof carry snow?
The structural engineer sets the snow and wind loads under Eurocode 1: EN 1991-1-3 (snow loads) and EN 1991-1-4 (wind actions). The values depend on the site. Snow can pile up at a parapet, and when it melts, the water needs clear outlets.
Can you put PV on a flat roof without a permit?
Under § 18 ods. 5 písm. i) of Act 25/2025, a device up to 50 kW inclusive needs no decision on the building intent and no notification. Yet § 18 ods. 4 písm. b) requires notification for solar devices. The act does not say which provision prevails, so ask the building office. The structural engineer checks the load.
Can new waterproofing go over the old?
First find the state of the build-up under the old waterproofing, for example with an infrared survey and samples (UFC). Remove wet insulation. Otherwise the moisture is sealed under the new membrane. The new materials must be compatible with the old ones, and the system manufacturer states this.
How long does flat roof waterproofing last?
It depends on the material, the seams and the maintenance. The only figure found in open sources is from UFC. It says a properly built system of welded PVC or TPO membranes may last 15 years or more. Look for other figures in the product data sheet and the warranty terms.
Can you put a green roof on a flat roof?
Only if the structural engineer shows that the roof can carry the added load of soaked substrate, and the system maker supports your build-up. On an older roof, also check the state of the waterproofing. A green roof on an existing house is usually a building alteration. The added load may be a case from § 18 ods. 3 písm. h of Act 25/2025. Then notification to the building office is required, so have the structural engineer assess it first.
Is there a subsidy for a green roof?
The current call of the municipality decides on it. Bratislava has a contribution of up to 50 % of the costs and at most 1,000 EUR per applicant. According to the city page, no call opens in 2026 (checked on 11 November 2026). In another municipality, ask the municipal office.
